Chapter 2: Design Methods

Engineering principles, failure analysis, decision logic, and design dimensions for video surveillance cabling systems.


2.1 Core Design Principles

Effective video surveillance cabling design is grounded in a set of engineering principles that have been validated across thousands of deployments. These principles are not merely guidelines — they represent the accumulated lessons from recurring failure patterns and the engineering controls that prevent them. Each principle is conditioned on specific deployment scenarios and backed by established references.

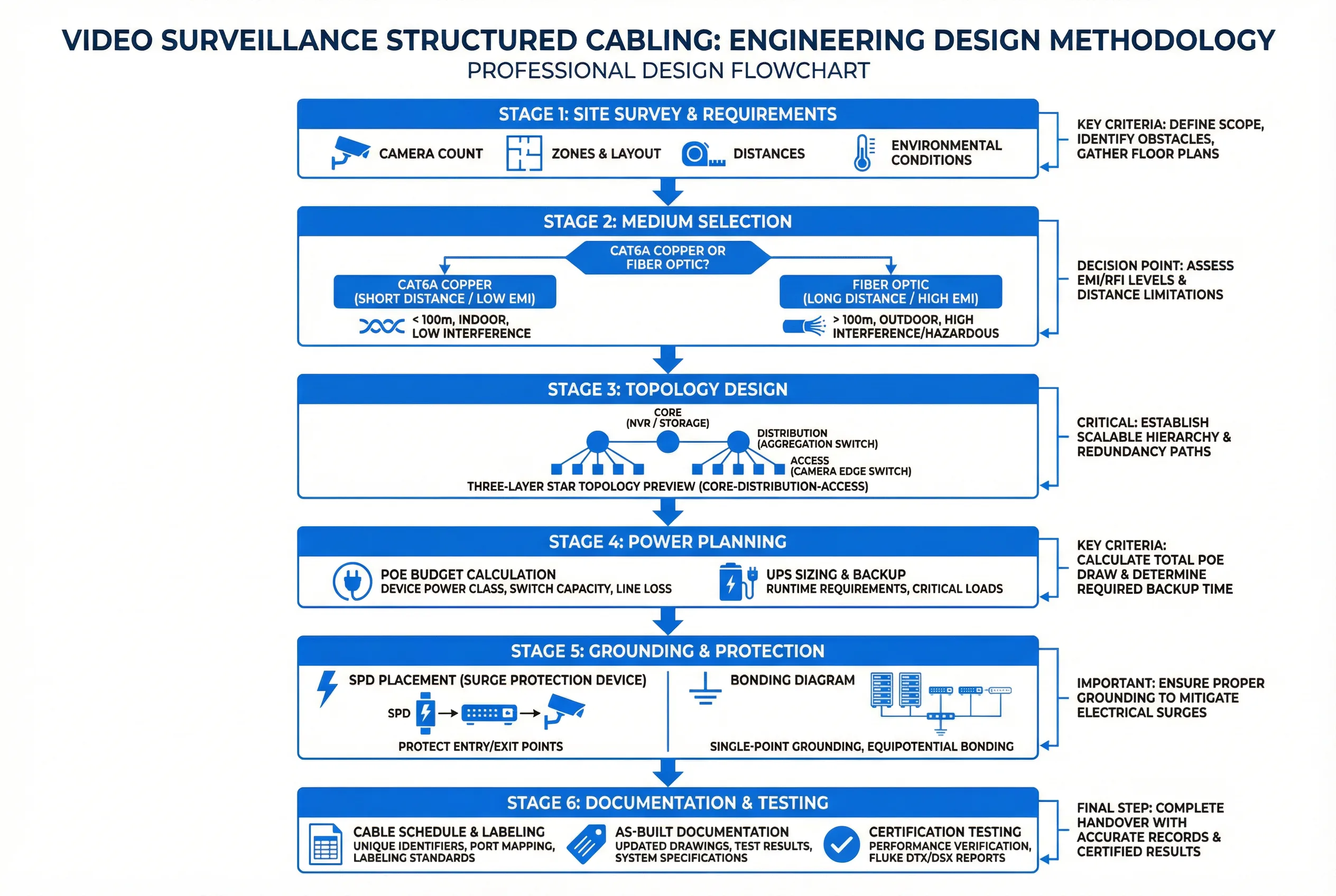

Engineering Design Methodology Flowchart

Figure 2.1: Engineering Design Methodology — Six-stage design process from site survey through documentation and testing acceptance.

Design Principle Condition / When Applicable Engineering Reference
Use structured cabling with patch panels — never direct-to-switch permanent cablesAll deployments with cabinetsStructured cabling methodology, maintainability
Keep copper short, use fiber for distance and outdoor aggregationChannels >90 m or high EMI zonesEthernet channel constraints + EMI immunity
PoE budget must include worst-case (night IR, heaters, PTZ motors)Outdoor IR/PTZ/thermal camerasVendor max power + thermal derating specs
Every permanent link must be testable and traceableAll deploymentsStructured cabling methodology
Pathway separation is a design control, not a construction detailCo-existing power, VFD motors, elevatorsEMC practices and separation standards
Use IP-rated enclosures and drip loops for outdoor terminationsOutdoor/parking/perimeterIngress protection practice (IP66/67)
Redundancy where repair time is unacceptableCritical perimeters, public safety zonesAvailability targets and MTTR analysis
Standardize labeling and numbering across civil, network, and VMSMulti-team operationsConfiguration management best practices
Design margins: thermal, power, bandwidth, spaceGrowth expected over 3–5 yearsCapacity planning methodology
Grounding and surge protection are mandatory interfacesOutdoor and long runsLightning/surge risk mitigation standards

2.2 Failure Causes and Recommendations

Understanding the most common failure mechanisms is essential for designing preventive controls into the cabling system from the outset. The following table maps each failure cause to its mechanism, typical symptoms, prevention strategy, and verification method. These patterns represent the most frequently encountered issues across enterprise and campus surveillance deployments.

Failure Cause Mechanism Typical Symptoms Prevention Verification
Bad terminationsHigh return loss/NEXTCRC errors, port flapsCertified installers + correct punch-down toolsCable certification PASS report
Wrong cable type outdoorsUV/water degradationSeasonal failures, crackingOutdoor-rated jacket (PE), sealed endsVisual inspection + spec check
Overfilled conduitsHeat + cable crushRandom drops, intermittentFill ratio control ≤40%Pathway audit during installation
EMI couplingInduced noise on copperPacket loss spikes near motorsSeparation, shielding, fiber in EMI zonesError counter trend monitoring
PoE oversubscriptionVoltage sag at far endNight reboot cyclesBudget + 20–40% headroomLoad test at peak power conditions
Poor labelingHuman error during opsWrong camera mapping, slow MTTRLabeling standards + print-before-installDocumentation audit sampling
Dirty fiber connectorsIncreased insertion lossUplink instability, CRC errorsMandatory cleaning procedure before patchOLTS measurement + DOM monitoring
No surge/ground bondingEquipment damage from transientsPost-storm port failuresSPDs + equipotential bondingContinuity test + installation checklist

2.3 Core Decision Logic

The design decision process follows a structured sequence that translates site requirements into specific engineering choices. Starting from camera count and bitrate policy, each decision step narrows the solution space based on measurable criteria. This prevents ad-hoc decisions that lead to inconsistent deployments across zones or sites.

  1. Define camera types and worst-case power/bitrate: Identify all camera models, their maximum PoE draw (including IR, heaters, PTZ), and their peak bitrate under motion conditions.
  2. Cluster cameras into zones and estimate distances to cabinets: Group cameras by physical proximity and measure or estimate the longest cable run in each zone. Runs approaching 90 m trigger fiber consideration.
  3. Choose access cabinet locations based on power availability, physical security, maintenance accessibility, and thermal environment.
  4. Select copper/fiber mix based on distance limits, EMI risk, lightning exposure, and budget. Outdoor runs longer than 30 m should default to fiber uplinks.
  5. Calculate bandwidth, PoE, UPS runtime, and fiber core counts using the formulas in Chapter 9 calculators, applying appropriate safety margins.
  6. Design pathways, separation, and grounding/SPD points — treat pathway routing as a primary design deliverable, not a construction afterthought.
  7. Finalize labeling, testing, and acceptance plan before installation begins, so test equipment and documentation templates are ready.
  8. Produce BOM and as-built requirements with revision control from day one of the project.

2.4 Key Design Dimensions Checklist

A complete design must address all seven dimensions listed below. Omitting any dimension creates a predictable failure mode that will surface during commissioning or operations. Use this checklist as a design review gate before finalizing any cabling design.

Dimension Key Questions Typical Acceptance Evidence
Performance / ExperienceIs latency, jitter, and frame integrity within spec?Throughput test, error counter baseline
Stability / ReliabilityAre link margin, power margin, and redundancy adequate?72h soak test, failover test
MaintainabilityCan any port be traced, patched, and repaired quickly?Traceability audit, MTTR measurement
Compatibility / ExpansionAre interfaces standards-based with spare capacity?Capacity check, spare fiber/port count
Lifecycle Cost (LCC)Is install cost vs. truck rolls vs. downtime optimized?LCC analysis, fault frequency tracking
Energy / EnvironmentAre PoE efficiency, UPS losses, and ventilation adequate?Power audit, thermal logging
Compliance / CertificationAre fire-stopping, low-voltage safety, and IP ratings met?Compliance checklist, certification reports
